Water Project Update: September 1
Check back on this post and on the Village website for developments.
See also the Village website home page.
9/1

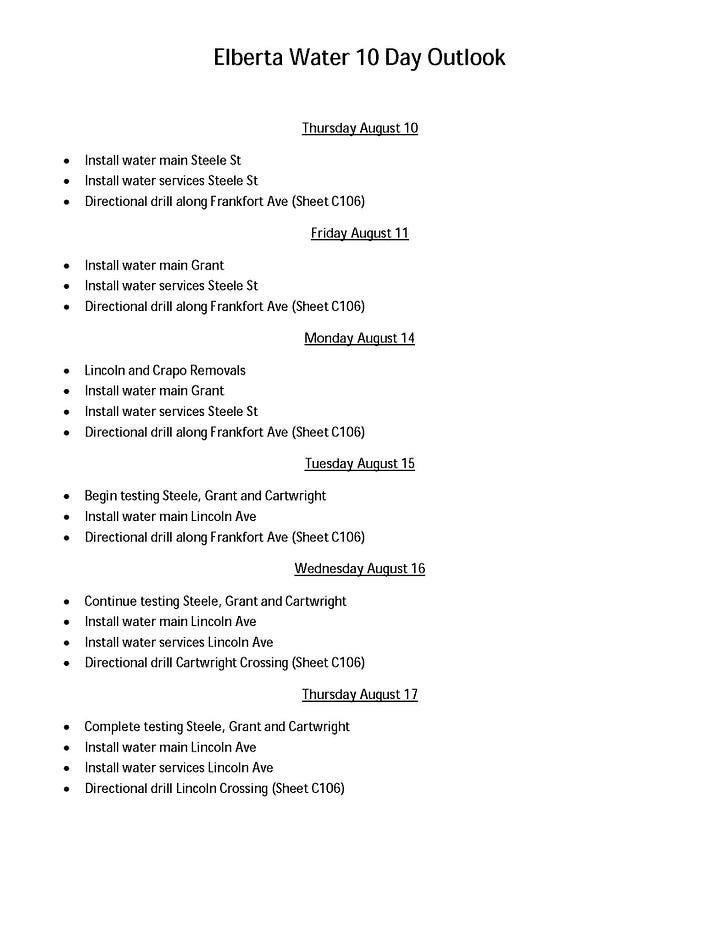

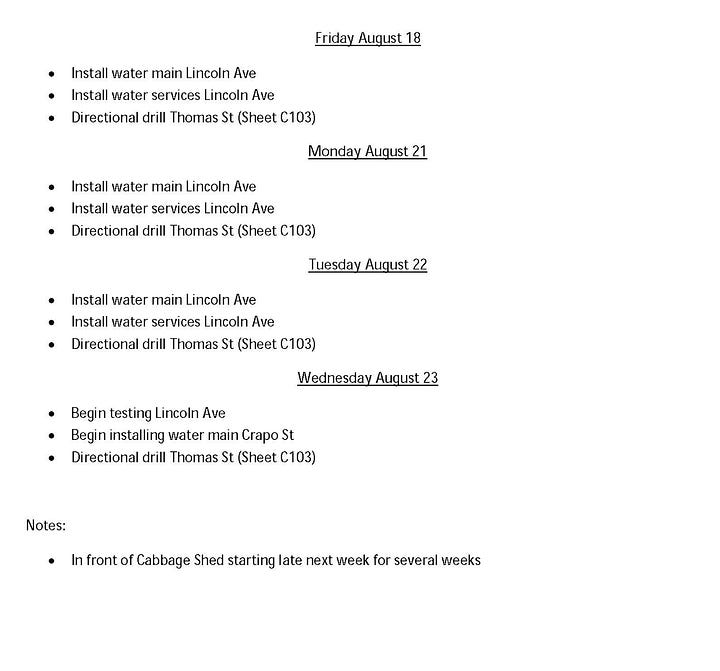

Here’s the latest predicted workflow for the 10 days up through September 13 from Elmer’s. Again, things can change.
8/23

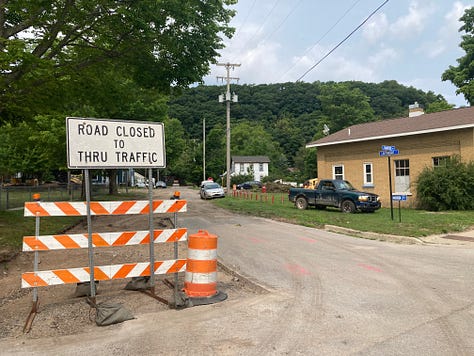

Straight from Elmer’s, here’s the updated schedule for the next 10 days (August 24 through September 6) and the long-term forecast. Village DPW continues to gather permissions from property owners to access properties for lead-line replacement as the need arises. If your block is on the schedule, be on the lookout for Justin Towle and/or Christopher Cervantes.

8/14

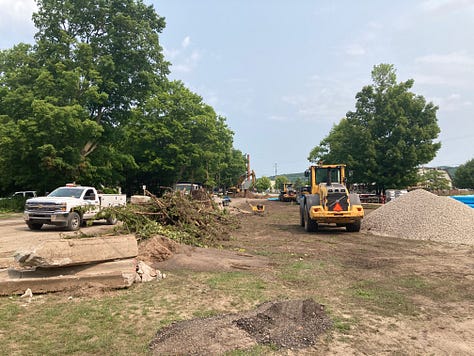

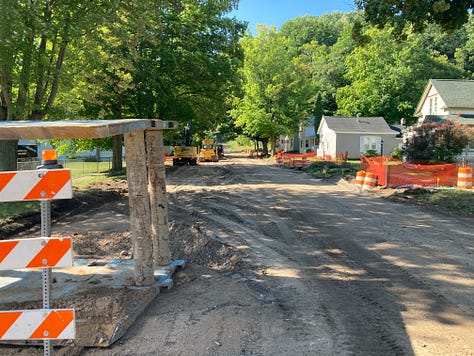

Per an 8/10 email from Elmer’s, they are running behind the last update (8/1) because of marl and water encountered on Steele/Cartwright. Mains are being removed on Lincoln and Crapo Streets this week and work will start around the Cabbage Shed late this week and will continue for several weeks.

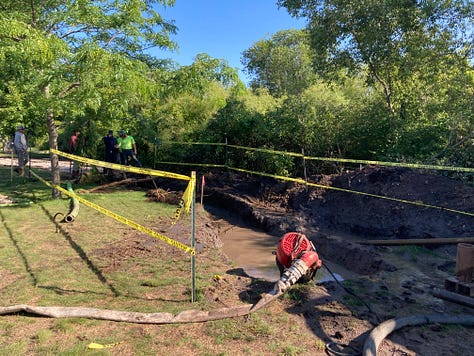

Corner of Steele and Cartwright looking at Veterans Park. Marl and water here have caused some delays. August 15, 2023.
8/2

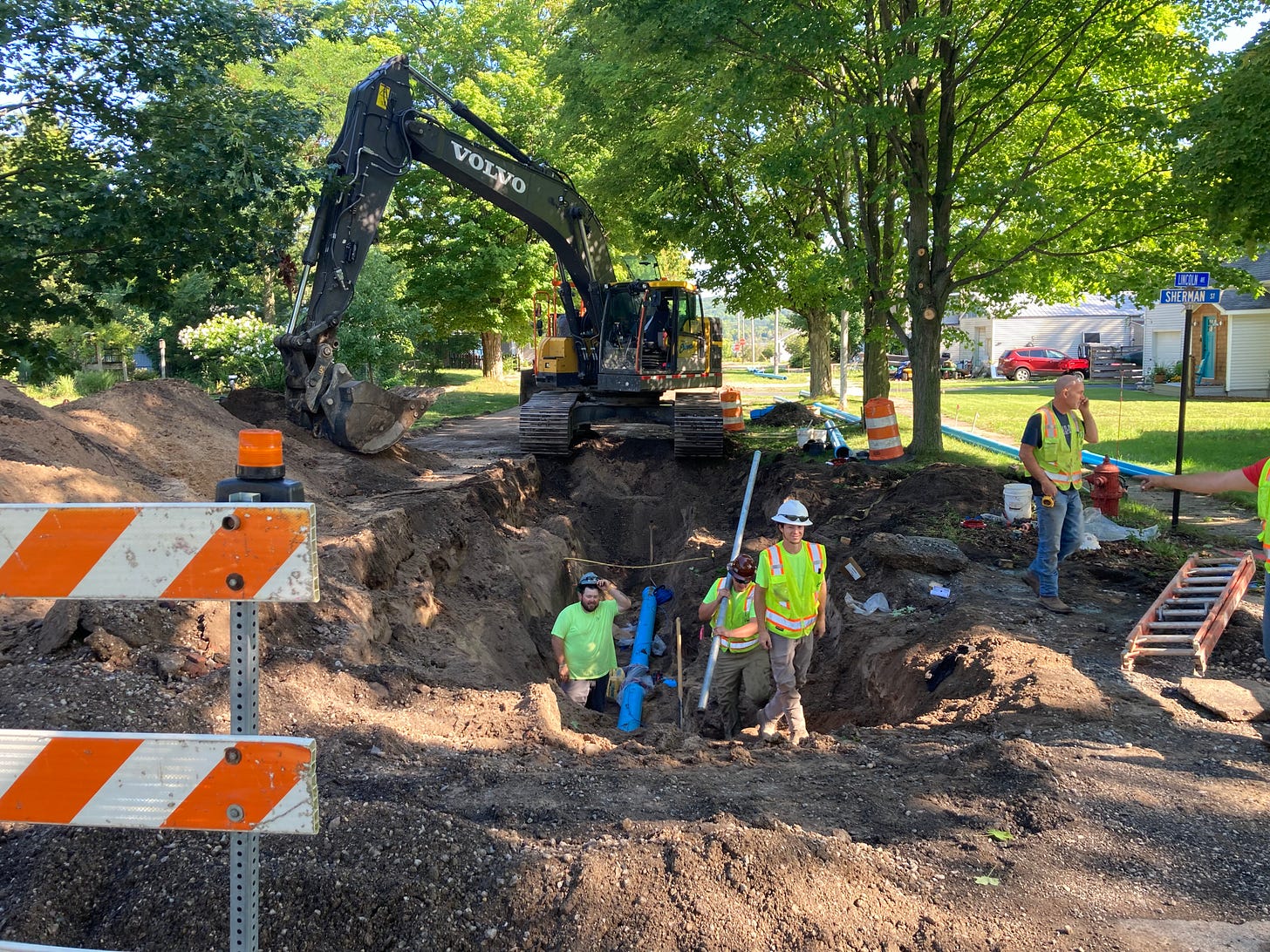

We received a 10-day forecast of activities from Nick Broad of Elmer’s. Again, this is subject to change. Service line installations are now expected to begin on Steele starting August 18, not 8, but the schedule below still gives some idea of the order of operations.
8/1

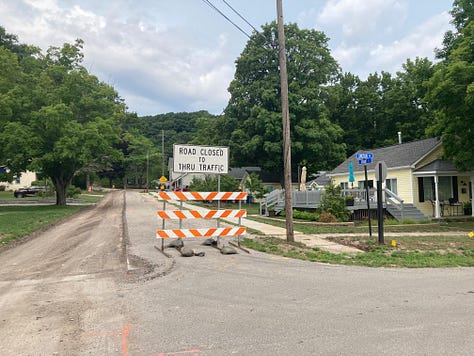

Work has begun on Steele, Cartwright, and Grant Streets (marked in yellow below). Some trees have been removed along the west side of Veterans Park.
